Ever feel like your project is running on hope and guesswork instead of real data? Some days, everything moves smoothly, but on others, delays accumulate, and deadlines start slipping.

The fix? A burndown chart—a must-have Agile tool that eliminates uncertainty, keeps progress transparent, and helps teams stay on track. Whether you’re managing a sprint or a full-scale project, this simple yet powerful visualization makes tracking work effortless.

But here’s the catch—if you’re using Microsoft Excel, setting up a burndown chart can be trickier than expected.

That’s why we’ve created this step-by-step guide to help you build a burndown chart in Excel in just a few simple steps. Let’s get started!

But first, here’s a template that can get you started quickly.

Summarize this article with AI ClickUp Brain not only saves you precious time by instantly summarizing articles, it also leverages AI to connect your tasks, docs, people, and more, streamlining your workflow like never before.
ClickUp Brain
Avatar of person using AI Summarize this article for me please

Successful projects need the perfect balance of time, resources, and planning. The ClickUp Burndown Chart Template is the perfect tool for helping your team visualize progress and quickly identify problems.

Visualizing project progress has never been easier—or more efficient! ClickUp’s burndown chart template will help make sure nothing slips through the cracks and get you back on track in no time.
Summarize this article with AI ClickUp Brain not only saves you precious time by instantly summarizing articles, it also leverages AI to connect your tasks, docs, people, and more, streamlining your workflow like never before.
ClickUp Brain
Avatar of person using AI Summarize this article for me please

What Is a Burndown Chart?

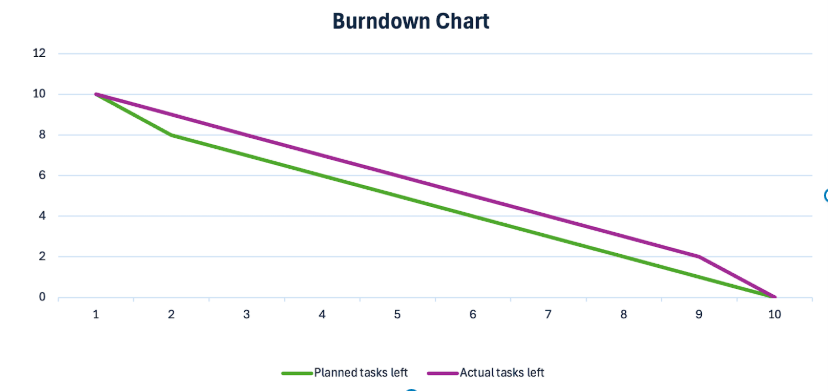

Burndown Chart ;' burndown chart excel
via Microsoft Excel

Burndown charts are straightforward graphs that show how much work remains versus the time remaining. They are visual to-do lists that act as your project’s GPS, highlighting whether your team is cruising smoothly towards project completion or heading for a roadblock.

While a sprint burndown chart focuses on tracking remaining tasks, agile teams also use burn-up charts to monitor completed work and project scope. The ability to visualize progress—without the guesswork—is precisely why burndown charts are a staple in Agile project management.

The components of a burndown chart

Now, let’s break down the key components of a burndown chart:

  • Time Axis: This is the horizontal scale on the graph that represents days, weeks, or even dates in the sprint in focus

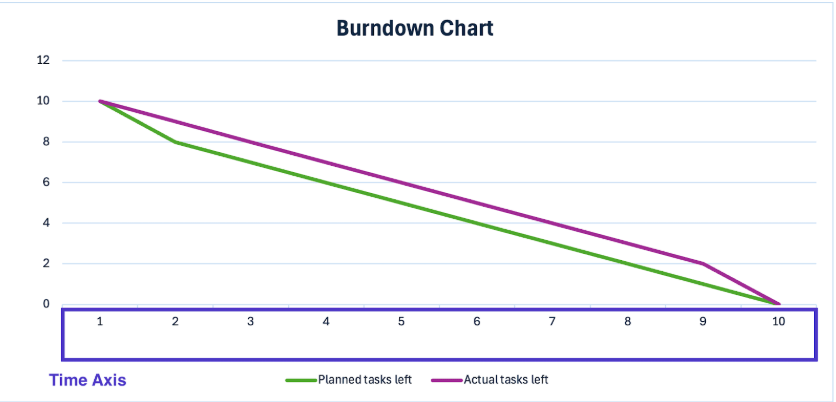

Time Axis ; burndown chart excel
  • Workload Axis: The vertical scale, generally on the left of the chart, tracks tasks, story points, or hours to showcase the project workload

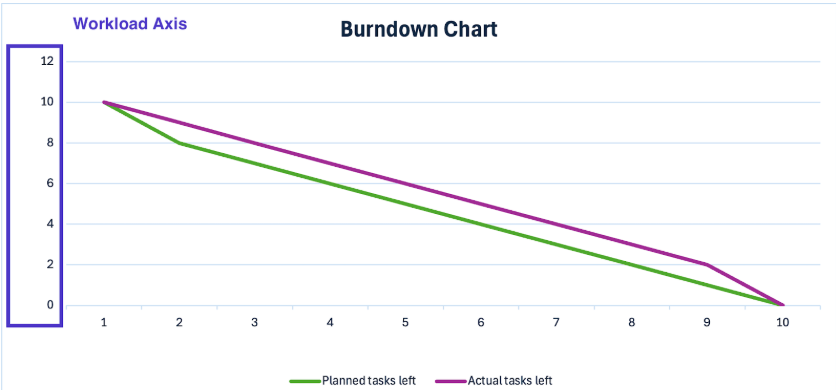

Workload Axis : burndown chart excel
  • Work Remaining Line: Based on the data table, the actual work line graph shows how many project tasks are left. The work remaining reflects how your team completes tasks and their progress

Work Remaining Line ; burndown chart excel
  • Ideal Work Line: This line graph shows how the project’s progress should unfold if tasks stay on track. It helps your team compare actual vs. expected progress at a glance

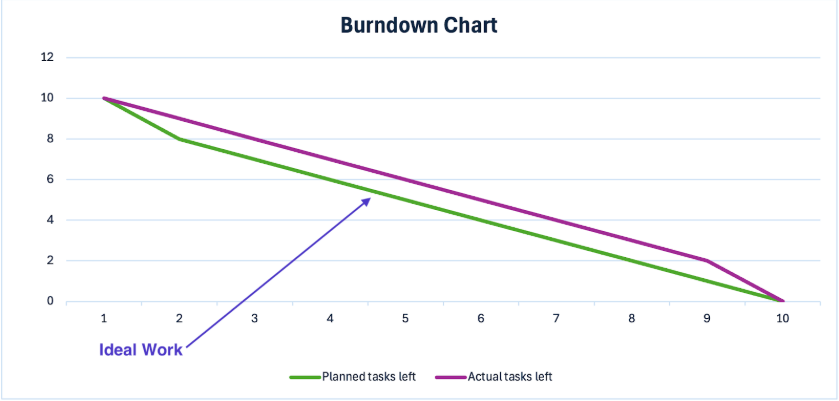

Ideal Work Line: ;' burndown chart excel

How to read a burndown chart?

A burndown chart in Excel is more than a visual—it’s a real-time performance check for your project.

Here’s how to interpret the data and make informed decisions:

  • Are we on track? If the actual progress line is higher than the ideal one, delays are creeping in
  • Are tasks taking longer than expected? A flat line means work isn’t getting done and hints at an operational issue that may need intervention
  • Are we working efficiently? When the remaining work line slopes downwards, that signals steady, efficient progress
  • Do we need to adjust? If progress is erratic, it might be time to redistribute tasks

Getting ahead of these insights helps teams avoid last-minute chaos and stay proactive. Simply put, burndown charts turn panic into planned success. 🚀

Let’s look at a few key scenarios where they make a significant impact:

  • Product launches and updates: Drives feature development and bug fixes before a major release. The burndown chart identifies scope creep early and allocates resources efficiently to meet the launch deadline
  • Event planning: Using a burndown chart for events, such as conferences or construction projects, visualize current bookings, pending confirmations, and supply delivery timelines. It ensures task completion before the event and minimizes last-minute hiccups
  • Task handovers: Tracking knowledge transfer before an employee’s exit or upcoming vacation helps avoid miscommunication. Adopting a burndown chart here crosses off key task handovers and boosts timeline-oriented efforts

🧠 Fun Fact: Burndown charts were originally invented by Ken Schwaber to monitor progress, specifically in Scrum. Today, it’s applicable in almost every agile methodology, including Kanban, Lean, and XP!

Summarize this article with AI ClickUp Brain not only saves you precious time by instantly summarizing articles, it also leverages AI to connect your tasks, docs, people, and more, streamlining your workflow like never before.
ClickUp Brain
Avatar of person using AI Summarize this article for me please

How to Create a Burndown Chart in Excel: Step-by-Step Guide

Ready to harness the power of burndown charts and put one into action? Let’s break it down and bring your project tracking to life in Microsoft Excel:

Step 1: Set up your data table

  • Start by opening Microsoft Excel, selecting ‘Blank Workbook’, and clicking ‘Create’ to set up your workspace. This table will serve as the foundation for your burndown chart

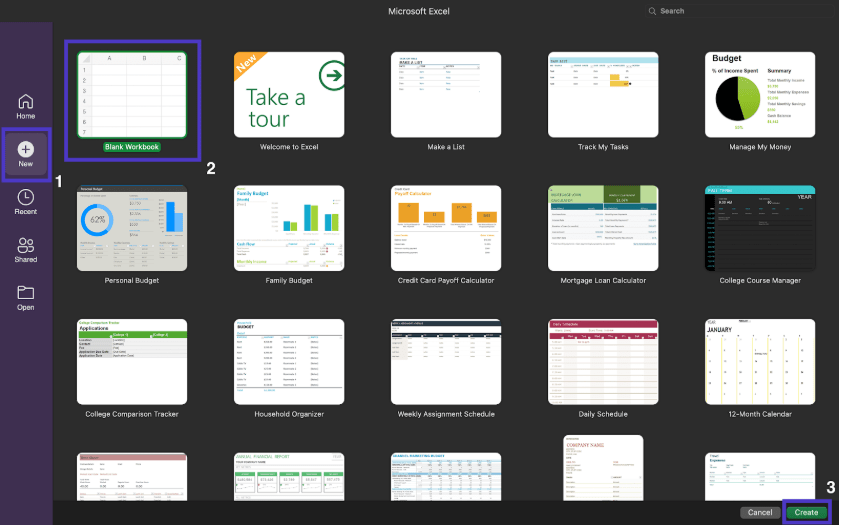

Set up your data table ; burndown chart excel
via Excel

Type in ‘Sprint duration,’ ‘Total tasks,’ ‘Day, ‘ ‘Planned tasks,’ and ‘Actual tasks left’

Set up your data table ; burndown chart excel

Step 2: Add the data (regularly!)

Once the structure is created, start adding the data.

Aside from the day or date, this includes:

  • Sprint duration: Total number of days the entire project will last
  • Total tasks: How many tasks you need to complete
  • Planned tasks: How many tasks you expect to end with on that day
  • Actual tasks left: How many tasks you end with on that day

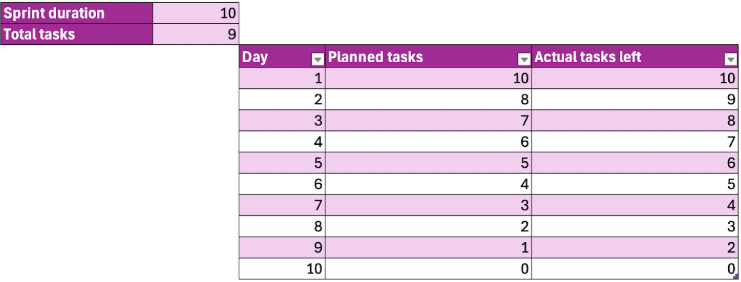

 Add the data (regularly!) ; burndown chart excel

Step 3: Insert a chart (nothing too complex)

With the data ready, let’s create the burndown chart.

Here’s what you need to do:

  • Select your table
  • Go to the ‘Insert’ tab
  • Click on ‘Line chart’ and choose a type that you like

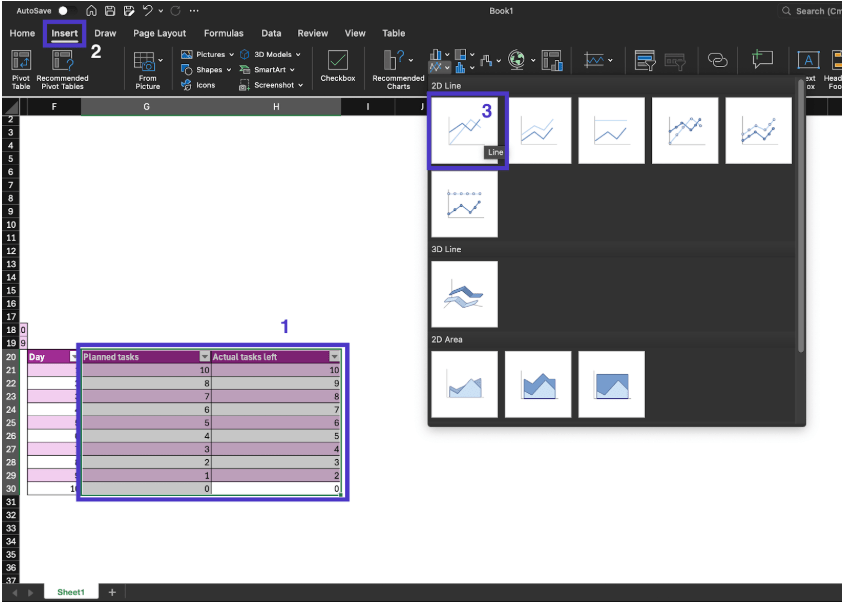

 Insert a chart

When the chart appears, this is what it’ll look like:

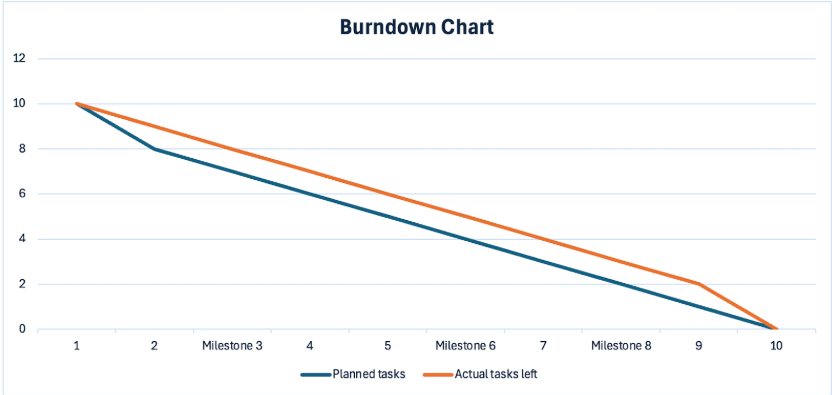

chart

🔎 Did You Know? Scrum teams were practicing Agile before the Agile Manifesto even existed! It debuted eight years earlier but is still considered an Agile methodology due to its iterative and incremental approach to project management.

Step 4: Add space for your analysis

While a clear chart helps your team adjust pace, many perspectives are behind the data in the actual tasks column. Here, adding a space beside the graph for insights lets everyone share observations.

This adds more depth to the visualization, helps managers identify issues early, and facilitates proactive resolution of bottlenecks.

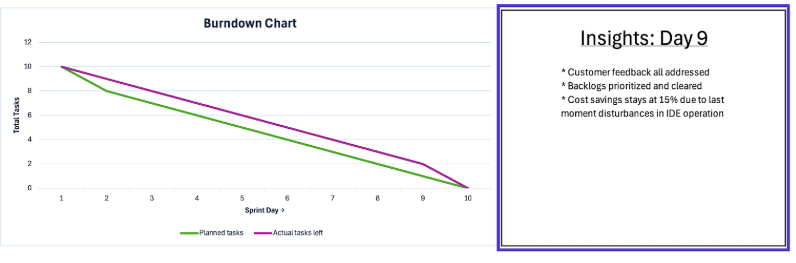

 Add a space to your analysis

Step 5: Tweak formatting and labels (the much-needed glow-up)

Finally, update the theme and data labels according to your project goals. This includes axis titles, data labels, line colors, layout changes, and more.

To add elements to the chart,

  • Click on the chart and go to ‘Chart Design’
  • Click on ‘Chart Elements’ to choose what you want to add
  • Pick ‘Axis Titles’ and name them. This drop-down also lets you add and position the data labels

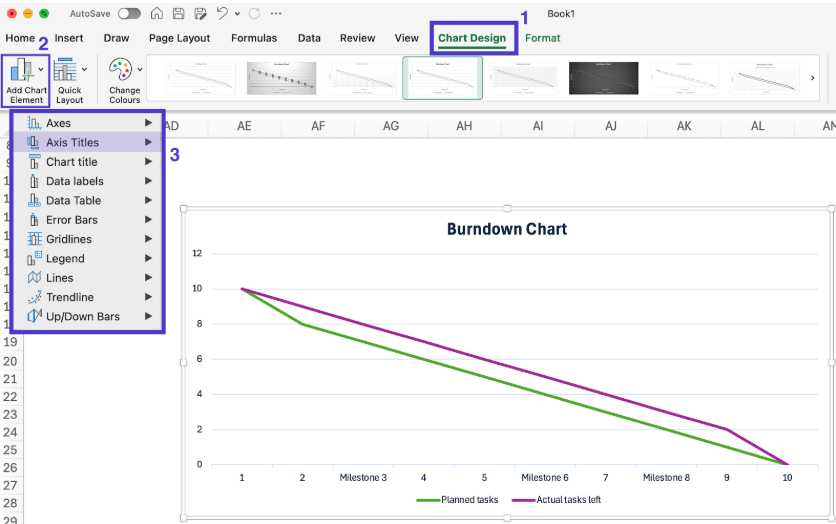

Tweak formatting and labels (the much-needed glow-up)

To change the color and text style, you’ll need to navigate to the ‘Format’ tab that appears on the top menu bar after selecting the chart.

While this step might seem optional, it’s essential—enhancing readability isn’t just a nice touch but a must when working with data-heavy tools like Excel.

With these refinements, your burndown chart is now complete! Here’s what it could look like:

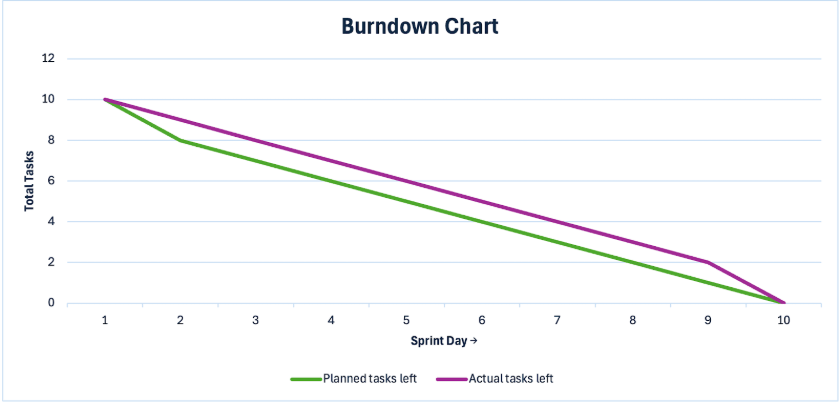

burndown chart is now complete

⚡️Bonus step: Create milestone markers

Milestones are key events in a sprint or project that require extra focus, such as completing a major software module or hitting a critical benchmark. Adding them to your burndown chart keeps your team aligned on important goals.

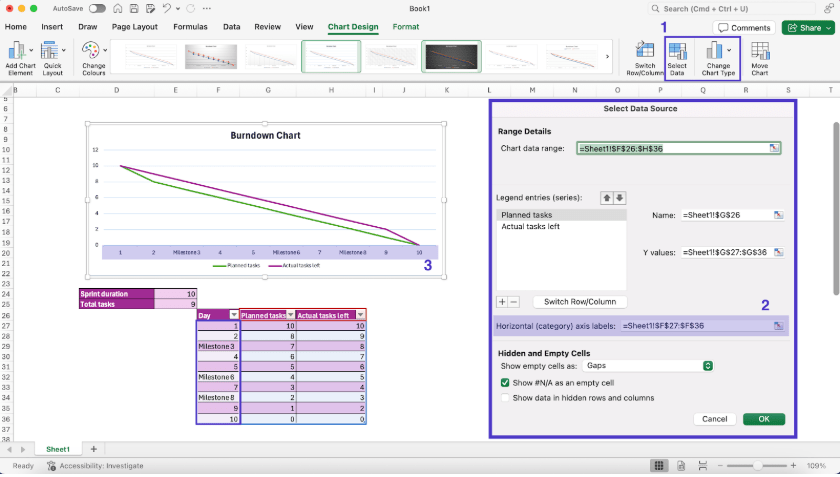

Create milestone markers

Here’s how to add milestones to your chart:

  • Add the word ‘Milestone’ to the sprint day when your team is expected to hit a milestone
  • Select the chart, choose ‘Chat Design,’ and click on ‘Select Data’
  • Navigate to ‘Horizontal (category) axis labels’ and select the updated cells

Once added, milestones will appear directly on your chart, making them easier to track during review meetings.

Summarize this article with AI ClickUp Brain not only saves you precious time by instantly summarizing articles, it also leverages AI to connect your tasks, docs, people, and more, streamlining your workflow like never before.
ClickUp Brain
Avatar of person using AI Summarize this article for me please

Limitations of Using Excel for Burndown Charts

Burndown charts are handy, but is Excel the best tool for creating them? A quick glance reveals its limitations, especially when compared to more dynamic project management tools.

Before committing to Excel, here are a few drawbacks to consider:

  • Tedious setup process: Creating, structuring, and formatting a burndown chart in Excel involves multiple manual steps, making it time-consuming and prone to errors—unlike modern project management charts that streamline the process effortlessly
  • Disconnected from action points: Tracking progress in Excel doesn’t link directly to tasks or updates in project management tools. Moving data to an external tab can lead to outdated insights, disconnecting the strategy from execution
  • Primarily manual updation: Updating progress in Excel requires constant manual input, increasing the risk of human error. Unlike AI-powered analytics tools, Excel won’t adjust your burndown chart dynamically
  • Limited collaboration features: Sharing content and making edits in Excel is far too basic for agile methodologies. While it does allow multi-user editing, Excel still lags in real-time updates and struggles with large projects
  • Lacks customization and visual appeal: Improving aesthetic appeal is not a cakewalk with Excel charts. It needs extra effort to improve readability and lacks interactive visual elements for better insights
Summarize this article with AI ClickUp Brain not only saves you precious time by instantly summarizing articles, it also leverages AI to connect your tasks, docs, people, and more, streamlining your workflow like never before.
ClickUp Brain
Avatar of person using AI Summarize this article for me please

Looking for a Smarter Alternative? Meet ClickUp

Agile teams need flexible, dynamic tools—not clunky, manual solutions. Given Excel’s limitations, it’s only natural to look for a smarter alternative.

This is where ClickUp comes in. As the everything app for work, it integrates task tracking, powerful visualizations, and AI-driven insights, ensuring your projects stay on track without hassle.

Plus, ClickUp integrates with 1,000+ tools, so you can seamlessly connect your favorite apps, automate workflows, and keep all your project data in one place.

Want to know how it stacks up against Microsoft Excel? Here’s a quick breakdown.

FeatureMicrosoft ExcelClickUp
Visualization setupManual and time-consumingAutomated and easy to generate
Real-time updatesLimited, requires manual refreshInstant updates with live tracking
Task integrationNone!Directly linked to tasks and workflows
CollaborationOnly multi-user editingSeamless real-time collaboration
CustomizationBasic built-in formatting options Advanced charts with interactive visuals
AutomationNone, apart from macros only the tech-savvy can workAI-powered automation and smart insights
ScalabilityStruggles with large datasetsHandles complex projects with ease
Ease of UseRequires formulas and manual formattingIntuitive, no-code setup for burndown charts

And here’s a breakdown of how ClickUp keeps your team ahead with powerful, Agile-focused features:

Analytics in visualizations

ClickUp Dashboards
Manage burndown cards in real time and customize visualizations to your unique preferences with ClickUp Dashboards

Looking for stellar insights? ClickUp Dashboards is the platform’s analytics powerhouse, turning raw data into clear, actionable visuals. It comes with dynamic burndown charts and real-time tracking, which can be connected to existing task lists.

Check out this video to find out how you can visualize your work, manage performance, and accelerate projects with ClickUp Dashboards.

You can go beyond basic charts with pre-defined dashboard templates like sales overviews, project roadmaps, and marketing expenditures. ClickUp also allows you to customize dashboards as widgets, monitor project progress, and spot roadblocks before they escalate.

Whether you’re building an agile dashboard for your software team or creating a high-level overview for executives, ClickUp Dashboards adapt to your needs, providing real-time insights that drive smarter decision-making.

💡Pro Tip: Add AI Cards to your dashboards in ClickUp to bring AI-powered insights and updates

Seamless automation

Cut out manual actions, streamline recurring task logic, and optimize how you manage project activities with ClickUp Automations

Want to free up your time for more creative and strategic work? ClickUp Automations has you covered.

With a few clicks, you can automate routine tasks such as updating assignees, changing task statuses, organizing folders, or sending notifications. ClickUp’s AI-powered Automations help you create seamless processes with ease.

Automations work seamlessly with ClickUp’s 1,000+ integrations, and with the custom ClickUp API, you can build tailor-made solutions for workflow synchronization, data visualization, and beyond.

In short, ClickUp Automations takes care of the busywork so you can focus on what really matters.

💡 Pro Tip: Want to boost project efficiency with visualization tools?

Here’s what you can do:

  • Use real-time dashboards to monitor progress at a glance 📊
  • Customize charts to spotlight key performance metrics 🎯
  • Automate data updates to keep insights accurate and up-to-date ⚡
  • Use color coding to identify trends and bottlenecks quickly 🌈

AI-powered updates

ClickUp Brain, the AI assistant integrated in ClickUp, can generate real-time project summaries, sprint updates, and executive summaries based on your workspace activity. You can quickly get overviews of progress, blockers, risks, and priorities without manually compiling data.

The AI can write standups, team updates, and project updates, summarizing what’s been accomplished and what’s left.

Set up specialized AI agents for specific tasks in ClickUp.

And that’s not all. AI Agents in ClickUp can help you build a consistent cadence of automated sprint updates. Here’s what you can get done through these ambient agents:

  • Scheduled updates: Set up a Prebuilt Agent (such as the Weekly Report, Daily Report, or Team StandUp Agent) to automatically post sprint updates at a specific time and frequency (e.g., every Friday at 5:00 PM). These Agents can be configured in your Sprint List or Folder
  • Automated summaries: The Agent will gather information from tasks, comments, and activity within the sprint location. It can summarize completed work, highlight blockers, and provide progress metrics without manual intervention
  • Custom instructions: You can customize the Agent’s instructions to tailor the update content—such as including only high-priority tasks, mentioning specific team members, or focusing on certain statuses
  • Posting updates: The Agent posts the update directly to a designated Chat Channel, task comment, or other workspace location, ensuring everyone receives the sprint summary in a consistent format

Just use the no-code builder to select triggers (like “on a schedule”), set conditions, and define the actions (such as “post a sprint update”). Agents can be set to act proactively (on a schedule) or reactively (when a trigger occurs, like a status change or comment).

Learn more about how to use AI agents for data analysis:

Summarize this article with AI ClickUp Brain not only saves you precious time by instantly summarizing articles, it also leverages AI to connect your tasks, docs, people, and more, streamlining your workflow like never before.
ClickUp Brain
Avatar of person using AI Summarize this article for me please

Master Agile Project Delivery With ClickUp

Burndown charts are powerful progress trackers that keep teams on course, optimize resources, and boost productivity. They’re so versatile that nearly every industry relies on them to stay ahead.

While we’ve outlined how to create a burndown chart in Excel, Excel isn’t always the most efficient option. The smarter choice? A tool that combines AI-powered insights, stunning visualizations, and seamless data management—exactly what ClickUp delivers.

With ready-to-use burndown chart templates, advanced automation, and powerful task management, ClickUp is built for Agile teams that want to work smarter, not harder.

Ready to take your Agile workflow to the next level? Sign up for ClickUp today!
